View ProjeQtOr On SourceForge.net
ProjeQtOr - Project Management Tool
Supportez nous sur Capterra
OIN - Open Invention Network
ProjeQtOr free project management software - [SOLVED] 8.1.8 Issue in devliverable update - ProjeQtOr

Prochaines Sessions

Les prochaines formations et démonstrations sont ouvertes, inscrivez-vous rapidement !



Démonstration de ProjeQtOr

(gratuit, sur inscription)


13 mai 2025 (10h30-12h)

5 juin 2025 (16h-17h30)




Planifiez avec ProjeQtOr

14 et 15 mai 2025 (9h-12h30)

18 et 19 juin 2025 (9h-12h30)




Administrez avec ProjeQtOr

20 et 21 mai (9h-12h30)

25 et 26 juin (9h-12h30)







[SOLVED] 8.1.8 Issue in devliverable update

More
17 Oct 2019 17:55 #1 by fsouliers
Hello,

I see it as a bug, but let me know if I am wrong : the planned date of a deliverable is only updated when associated with a milestone, not when the planning changes the date of the milestone. As a consequence, the planned date of the deliverables are very complicated to use (they are wrong most of the time).

Actually, from my experience, the expected behavior would be :
- if the milestone is a fixed one : the milestone forces the 'due date' of the deliverable, the planned date is what the project manager actually expects to happen.
- if the milestone is a floating one : the deliverable is a predecessor of the milestone, in this case the due date of the deliverable is the validated date of the milestone.

my 2 cents :)

Please Connexion or Create an account to join the conversation.

More
18 Oct 2019 09:13 #2 by babynus
Which version are you using ?
I thought this issue was fixed on V8.1.1

Babynus
Administrator of ProjeQtOr web site

Please Connexion or Create an account to join the conversation.

More
18 Oct 2019 09:27 #3 by fsouliers
Hey,
I am using 8.1.8

Please Connexion or Create an account to join the conversation.

More
18 Oct 2019 10:53 #4 by babynus
Hi,

I cannot reproduce.

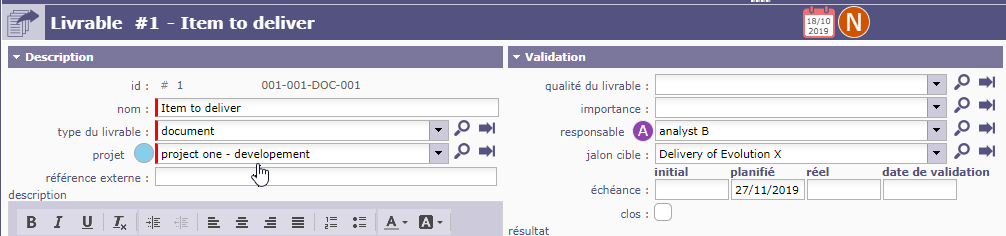

It works fine (as expected) for me.

I have a plannig with a milestone

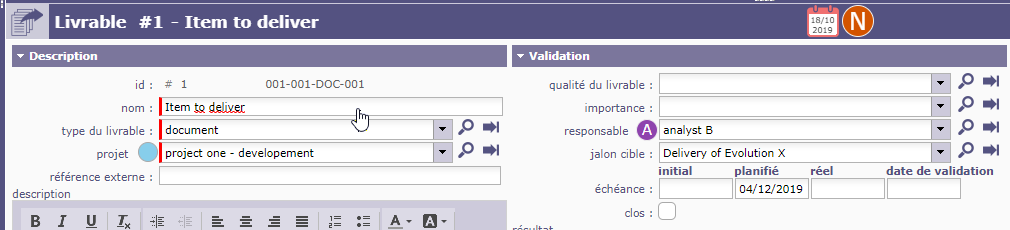

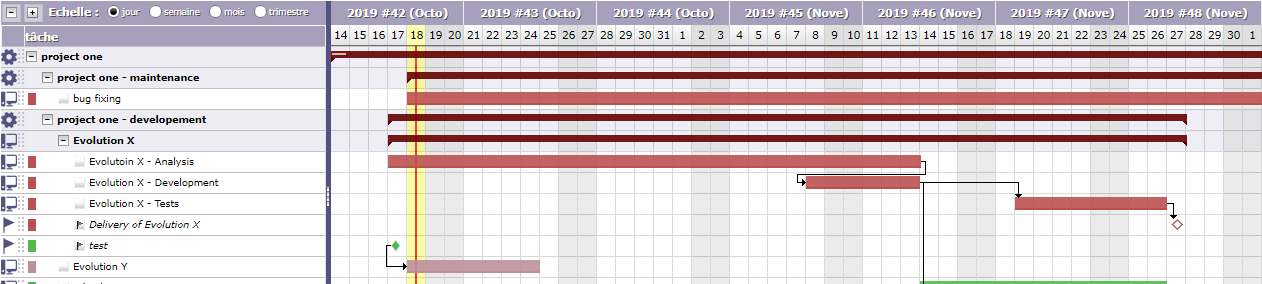

I linkk a deliverable to the milestone : planned due date fits milestone planned date


I change data to indirectly change milstone planned date :

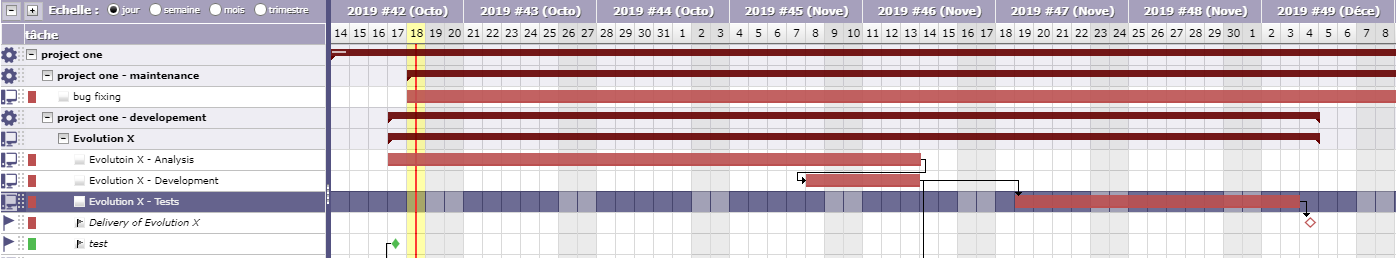

Due date of deliverable has been updated to fit milestone planned date


Could you please try and reproduce on Demo ?

Babynus
Administrator of ProjeQtOr web site
Attachments:
The following user(s) said Thank You: fsouliers

Please Connexion or Create an account to join the conversation.

More
25 Oct 2019 10:49 #5 by fsouliers
Hello,

it works, I wrote too fast when answering before :oops:
I had the problem with 8.0.6 and wrote the message as I was updating our version to 8.1.8 (actually, when I wrote the message, I had a test version in 8.1.8 and a production version in 8.0.6 ... and I did not perform the test in the good window).

I am really sorry, all my apologies. :(

Please Connexion or Create an account to join the conversation.

Moderators: babynusprotion
Time to create page: 0.072 seconds

Paramétrages de cookies

×

Cookies fonctionnels

Ce site utilise des cookies pour assurer son bon fonctionnement et ne peuvent pas être désactivés de nos systèmes. Nous ne les utilisons pas à des fins publicitaires. Si ces cookies sont bloqués, certaines parties du site ne pourront pas fonctionner.

Session

Veuillez vous connecter pour voir vos activités!

Autres cookies

Ce site web utilise un certain nombre de cookies pour gérer, par exemple, les sessions utilisateurs.
