ProjeQtOr free project management software - [Import Project] in Demo V9.0.2 - Validated and Requested Dates Empty - ProjeQtOr


[Import Project] in Demo V9.0.2 - Validated and Requested Dates Empty

More
13 Jan 2021 05:10 #1 by rainbow
Hi,

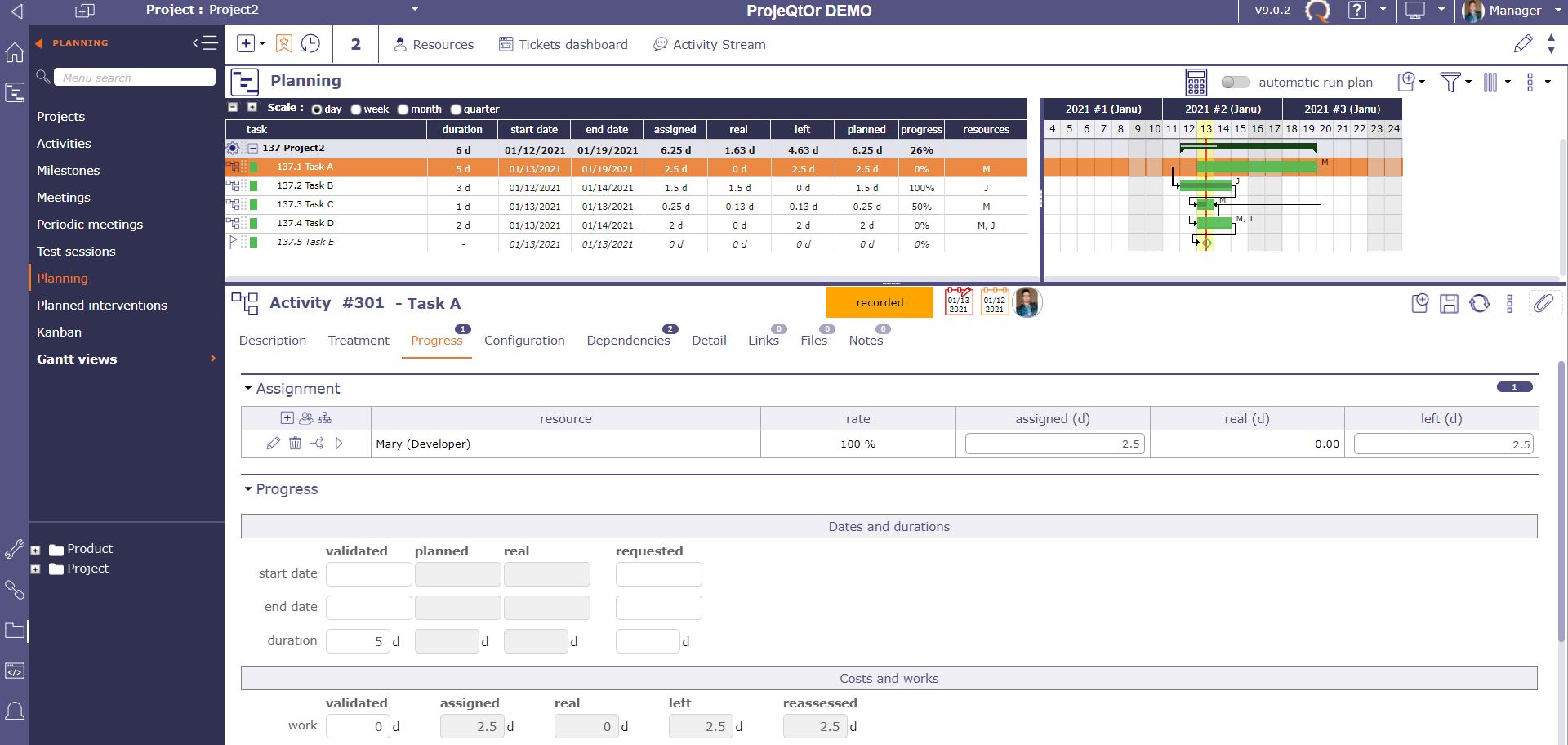

I tried to import MS project in demo V9.0.2 and found out that the start and end dates are not filled in to the validated and requested dates.



Moreover, I would like to ask whether it is possible to supposed to import notes from MS project as well?

Thanks,
Rainbow
Attachments:

Please Connexion or Create an account to join the conversation.

More
13 Jan 2021 19:41 #2 by babynus

I tried to import MS project in demo V9.0.2 and found out that the start and end dates are not filled in to the validated and requested dates.

Yes, change of validated dates should be done through Projeqtro feature "Validate planning"

Moreover, I would like to ask whether it is possible to supposed to import notes from MS project as well?

I was note aware you coulde save note on MS-Project...
We'll have a look.

Babynus
Administrator of ProjeQtOr web site

Please Connexion or Create an account to join the conversation.

More
14 Jan 2021 07:35 #3 by rainbow
Hi,

Could the start and end dates in MS Project be imported as validated/requested dates in order to keep the initial requested plan dates?

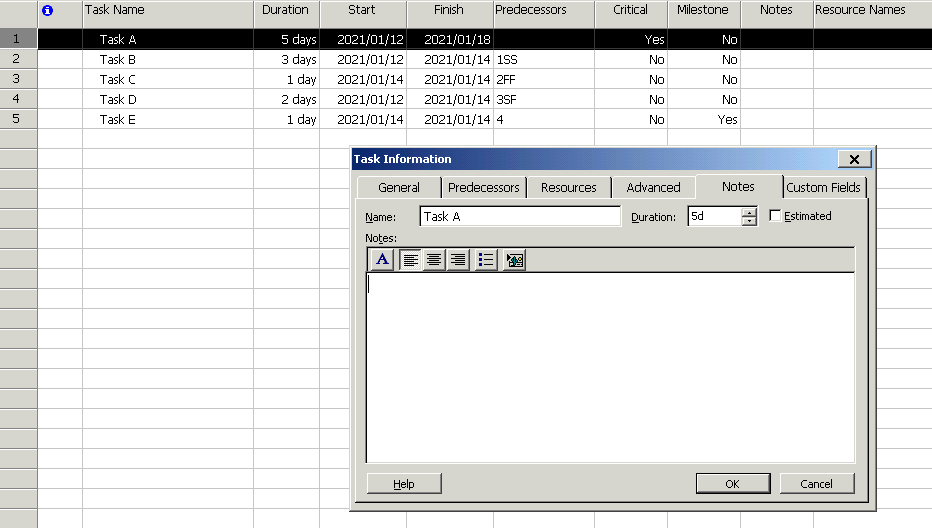

FYI, for the notes, it is a defined field in MS Project.


Thanks,
Rainbow
Attachments:

Please Connexion or Create an account to join the conversation.
