View ProjeQtOr On SourceForge.net
ProjeQtOr - Project Management Tool
Supportez nous sur Capterra
OIN - Open Invention Network
ProjeQtOr free project management software - Planning Calculation Logic - ProjeQtOr

Prochaines sessions de formation

Les prochaines formations et démonstrations sont ouvertes, inscrivez-vous rapidement !



Démonstration de ProjeQtOr

(gratuit, sur inscription)

Mardi 23 avril (10h30-12h)

Jeudi 16 mai (16h-17h30)

Jeudi 13 juin (10h30-12h)




Planifiez avec ProjeQtOr

3 et 4 avril (9h - 12h30)




Administrez avec ProjeQtOr

10 et 11 avril (9h - 12h30)








Planning Calculation Logic

More
07 Avr 2021 04:52 #1 by rainbow
Hi,

I would like to ask whether there are any detail description on the planning calculation logic in addition to the user manual on the "PROJECT PLANNING CALCULATION" ?

I noticed that for some tasks, the planning calculation planned the task to dates and work assignment which differ from the defined validated dates, planning mode, and resource allocation rate. In addition, for some tasks, even with the planning calculation option - "Plan with overuse (infinite overbooking capacity)" selected, the calculation did not plan overuse or skipped allocation on certain days (which the resource still has capacity for allocation) which cannot meet the validated dates with planning mode - "Regular between dates".

Thanks,
Rainbow

Please Connexion or Create an account to join the conversation.

More
09 Avr 2021 15:28 #2 by babynus
Replied by babynus on topic Planning Calculation Logic

I would like to ask whether there are any detail description on the planning calculation logic in addition to the user manual on the "PROJECT PLANNING CALCULATION" ?

No, user manual doies not enter into such detail.
But during our training courses, we explore this subjet. ;)


Babynus
Administrator of ProjeQtOr web site

Please Connexion or Create an account to join the conversation.

More
12 Avr 2021 07:58 #3 by rainbow
Replied by rainbow on topic Planning Calculation Logic
Hi Babynus,

Thanks for your reply. Good to know that training courses would be helpful.

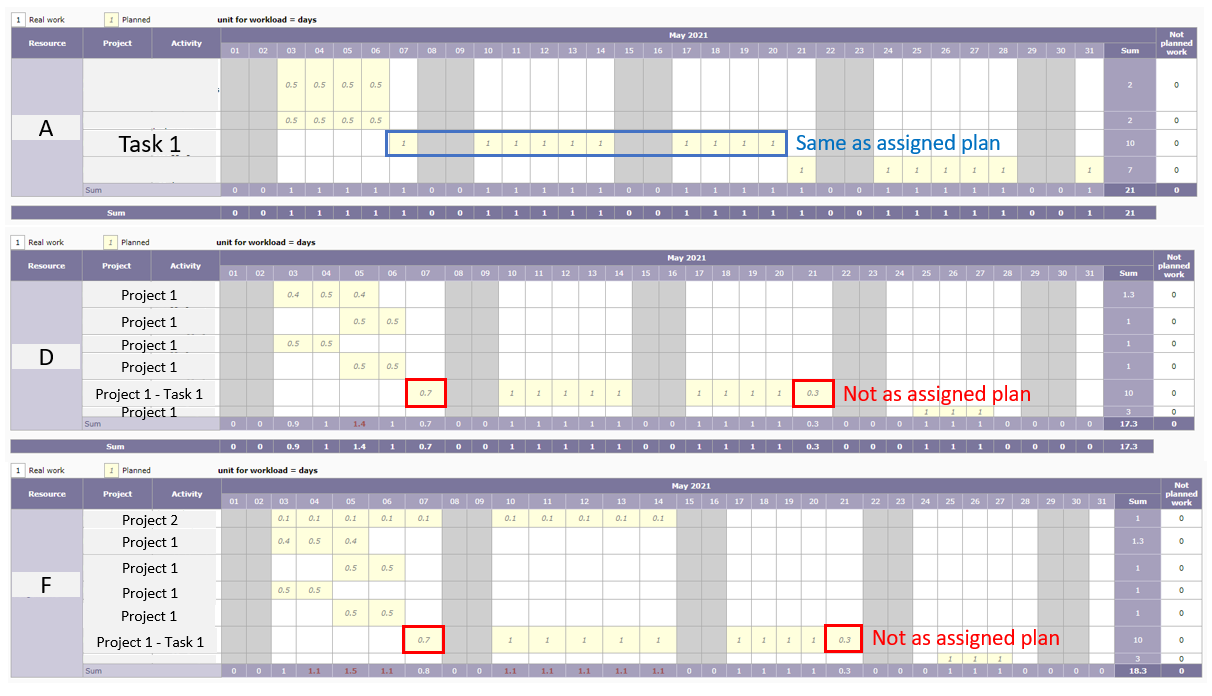

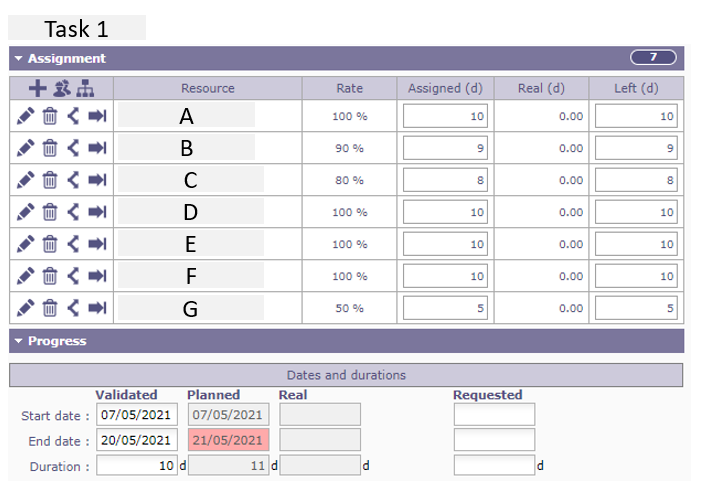

Just want to check if the cases mentioned in previous post are normal or there are bugs/setting issues in the calculation. I tried to repeat a case mentioned and attached the screenshots for your reference. The task validated start date is 2021/5/7 and end date is 2021/5/20 with planning mode as soon as possible. In the assigned resources, a few have work allocated on 2021/5/21 instead, while they have capacity on 2021/5/7 such that the work can be distributed within 2021/5/7 and 2021/5/20. In the plan calculation, the planning calculation option - "Plan with overuse (infinite overbooking capacity)" is selected. Is there any issue in the calculation or settings required?

Appreciate for your advice. Thanks.

Rainbow
Attachments:

Please Connexion or Create an account to join the conversation.

More
13 Avr 2021 14:45 #4 by babynus
Replied by babynus on topic Planning Calculation Logic
Yes, this mays be accurate.
The "Plan with overuse (infinite overbooking capacity)" will have effect only between project.
This means the resource will be planned on several project for its full capacity.
But inside same project, capacity of resource is respected, otherwise, every activity "as soon as possible" will be done in one single day ;)
So the calculation may be correct if the ressource is busy on another activity on same project.

Babynus
Administrator of ProjeQtOr web site
The following user(s) said Thank You: rainbow

Please Connexion or Create an account to join the conversation.

More
14 Avr 2021 03:46 #5 by rainbow
Replied by rainbow on topic Planning Calculation Logic
Hi Babynus,

Many thanks for your explanation on the calculation. I think the situation you mentioned does explain for some of the cases, while for the case mentioned in previous post, for resource D and F, all the tasks assigned to them are shown in the screenshot. For resource D, all the task shown in the screenshot belongs to the same project. For resource F, except the first row, other tasks shown in the screenshot are the same project as resource D. If accordingly to your explanation, day May 7 should be able to plan workload = 1 day such that the workload would be allocated through till May20 instead of May 21, right? Please advise there is any misunderstanding. Thanks!


Attachments:

Please Connexion or Create an account to join the conversation.

More
14 Avr 2021 08:56 #6 by babynus
Replied by babynus on topic Planning Calculation Logic
There seem to be something that take 0.3 days for each on may 7th.
A Meeting ?
Some already entered real work ?

Babynus
Administrator of ProjeQtOr web site

Please Connexion or Create an account to join the conversation.

Moderators: babynusprotion
Time to create page: 0.059 seconds

Paramétrages de cookies

×

Cookies fonctionnels

Ce site utilise des cookies pour assurer son bon fonctionnement et ne peuvent pas être désactivés de nos systèmes. Nous ne les utilisons pas à des fins publicitaires. Si ces cookies sont bloqués, certaines parties du site ne pourront pas fonctionner.

Session

Veuillez vous connecter pour voir vos activités!

Autres cookies

Ce site web utilise un certain nombre de cookies pour gérer, par exemple, les sessions utilisateurs.
