View ProjeQtOr On SourceForge.net
ProjeQtOr - Project Management Tool
Supportez nous sur Capterra
OIN - Open Invention Network
ProjeQtOr free project management software - Charge Unity - ProjeQtOr

Prochaines Sessions

Les prochaines formations et démonstrations sont ouvertes, inscrivez-vous rapidement !



Démonstration de ProjeQtOr

(gratuit, sur inscription)


13 mai 2025 (10h30-12h)

5 juin 2025 (16h-17h30)




Planifiez avec ProjeQtOr

14 et 15 mai 2025 (9h-12h30)

18 et 19 juin 2025 (9h-12h30)




Administrez avec ProjeQtOr

20 et 21 mai (9h-12h30)

25 et 26 juin (9h-12h30)







Charge Unity

More
13 Juil 2021 12:20 #1 by SEB-SEB
Charge Unity was created by SEB-SEB
Hi there,

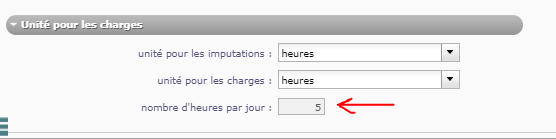

I would like to change in ProjeQtOr parameter the worth of unity charge.
Currently, it's 5h. I would like to change by 7h.

How do you do ?

Attachments:

Please Connexion or Create an account to join the conversation.

More
15 Juil 2021 09:07 #2 by alainforma
Replied by alainforma on topic Charge Unity
hi,

modify hour per day and then change this number.

Please Connexion or Create an account to join the conversation.

More
15 Juil 2021 09:18 #3 by SEB-SEB
Replied by SEB-SEB on topic Charge Unity
Hi Alain,

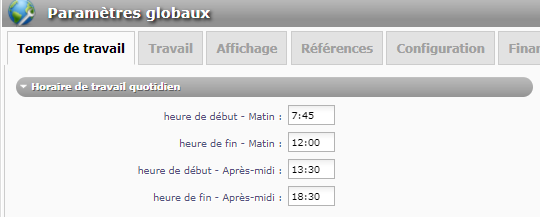

I did that (Screenshot) after have to save but any change.

Attachments:

Please Connexion or Create an account to join the conversation.

More
15 Juil 2021 12:05 - 15 Juil 2021 12:14 #4 by alainforma
Replied by alainforma on topic Charge Unity
no way this screen.

Parameters on the first pic you showed us.

Change the unit  hours by day,  then change the number of hours, then come back from day to hours. The Number of hours will be kept. it is a trick. It is not recommended to change the duration of work by day. Indeed, from now with this new unit, some workload will be missing on the past,  just to keep in mind reading reports and so on.
Last edit: 15 Juil 2021 12:14 by alainforma.

Please Connexion or Create an account to join the conversation.

More
16 Juil 2021 10:33 #5 by babynus
Replied by babynus on topic Charge Unity
In addition to Alainforma's remark, you should not change hours per day parameter when some real work exist.
Keep in mind that Projeqtor stores work in days. So enter and display in hours is a conversion.

You have 5 hours per day.
If you have a user who entered 5 hours for a day in timesheet, projeqtor stored value 1 (1 day)
Now if you change hours per day to 10, same user reading his timesheet now sees 10 although he entered 5...

Babynus
Administrator of ProjeQtOr web site

Please Connexion or Create an account to join the conversation.

Moderators: babynusprotion
Time to create page: 0.055 seconds

Paramétrages de cookies

×

Cookies fonctionnels

Ce site utilise des cookies pour assurer son bon fonctionnement et ne peuvent pas être désactivés de nos systèmes. Nous ne les utilisons pas à des fins publicitaires. Si ces cookies sont bloqués, certaines parties du site ne pourront pas fonctionner.

Session

Veuillez vous connecter pour voir vos activités!

Autres cookies

Ce site web utilise un certain nombre de cookies pour gérer, par exemple, les sessions utilisateurs.
