View ProjeQtOr On SourceForge.net
ProjeQtOr - Project Management Tool
Supportez nous sur Capterra
OIN - Open Invention Network
ProjeQtOr free project management software - [SOLVED] strange behavior using planned date for project (bug ?) - ProjeQtOr


[SOLVED] strange behavior using planned date for project (bug ?)

More
30 Sep 2021 14:47 - 30 Sep 2021 14:48 #1 by ileduc
Hello,
We are currently using v9.2.4.
Using project and planned date, I come accross a strange behavior (maybe a bug ?) on all of our project.

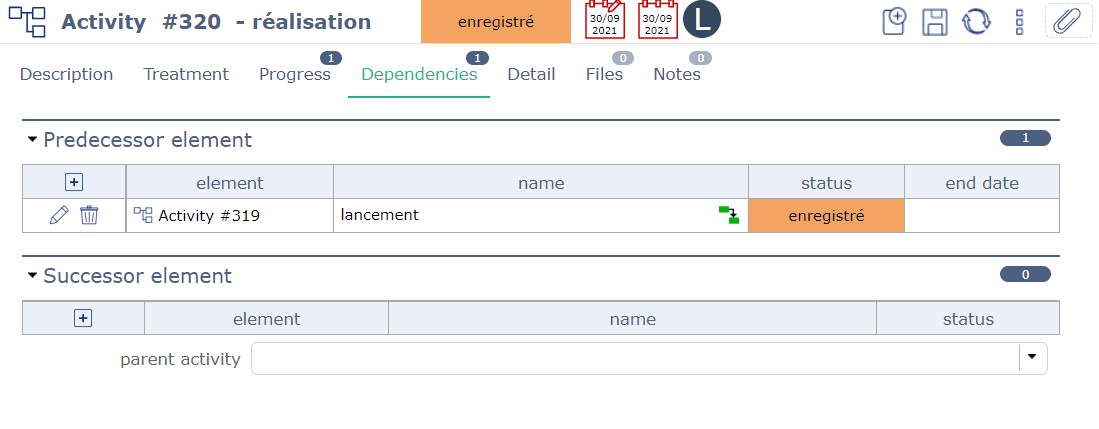

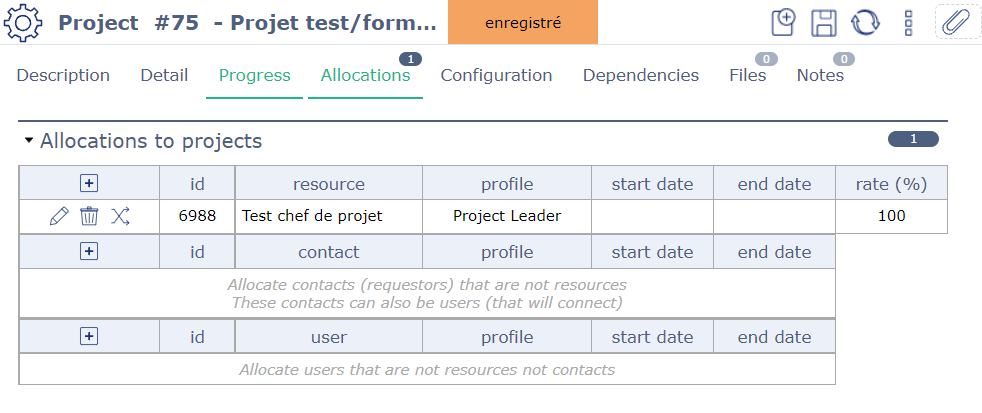

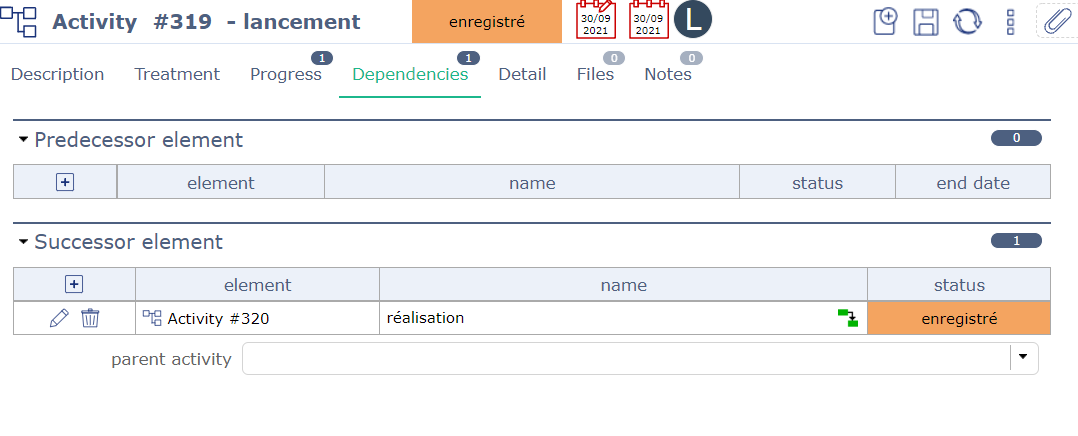

I have a created a very simple project for the purpose of the explanation (see screenshots : project 75, activity 319 and activity 320):
- The project 75 has 2 activities, linked with a dependancy (319 « lancement » is predecessor of 320 « réalisation »)

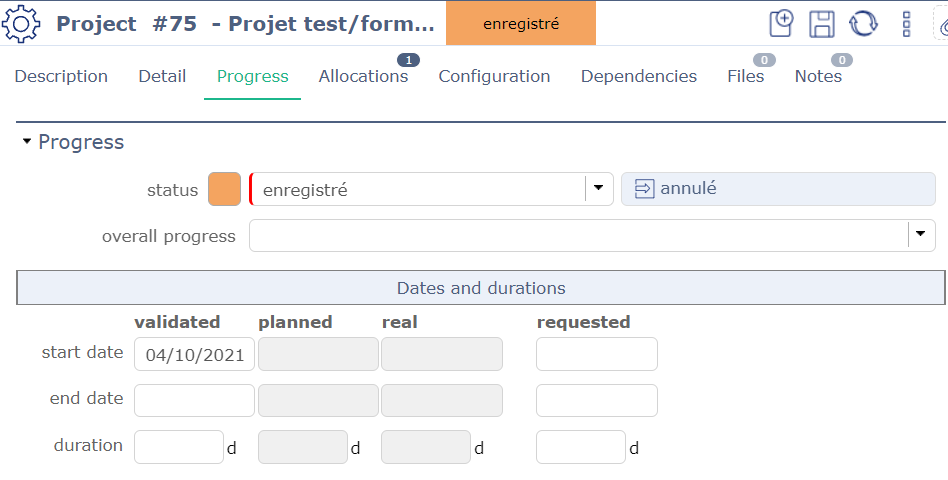

- The project starts the 04/10/2021
- The two activities has an assignement (resource Test chef de projet), for 5 days each
                o   The resource is not staffed on any other project on october
-  Activities are on « as soon as possible » planning mode

My understanding, after reading the user manual, is that planned date are calculated using the assignement, dependencies and planning mode. In my case, I am expecting an activity 319 ending on 08/10 and the activity 320 to start on 11/10 and finish on 15/10.

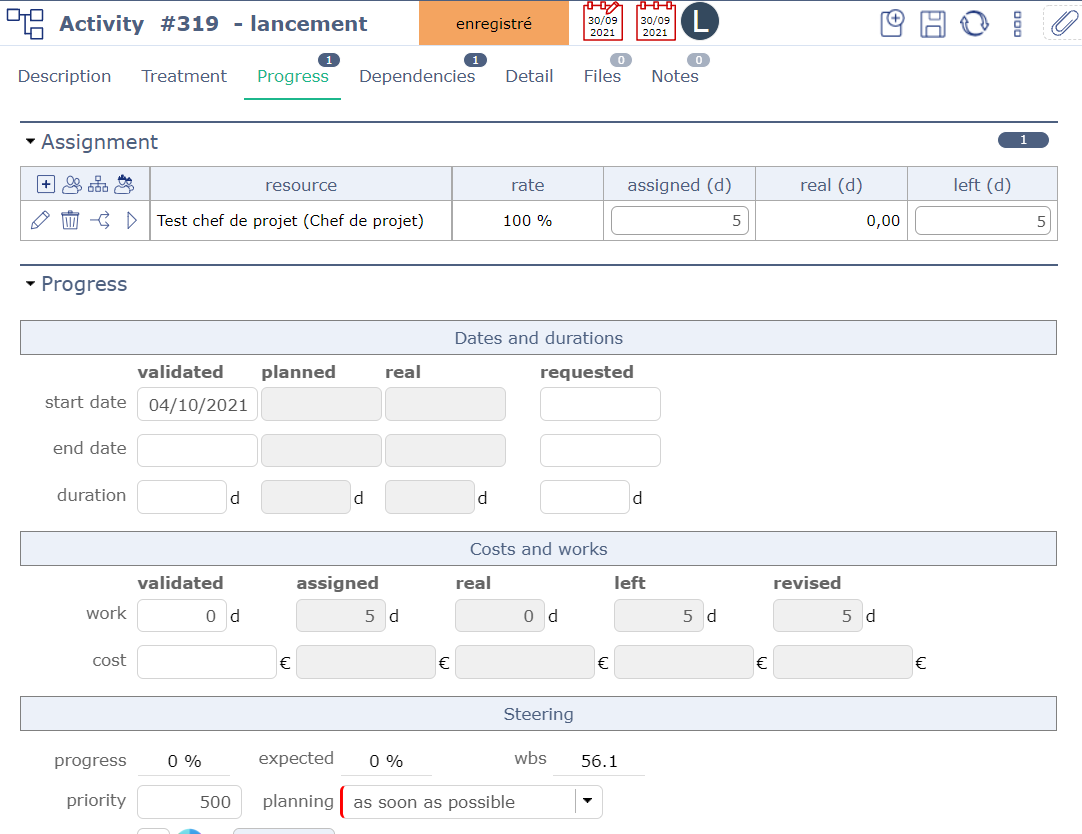

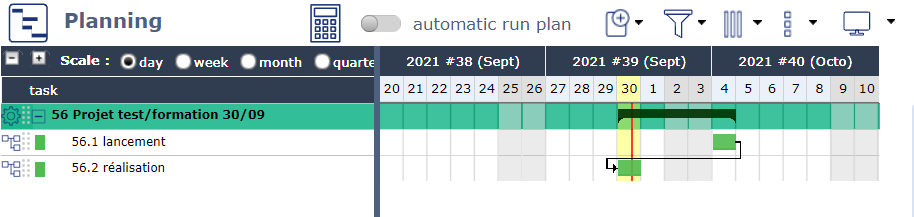

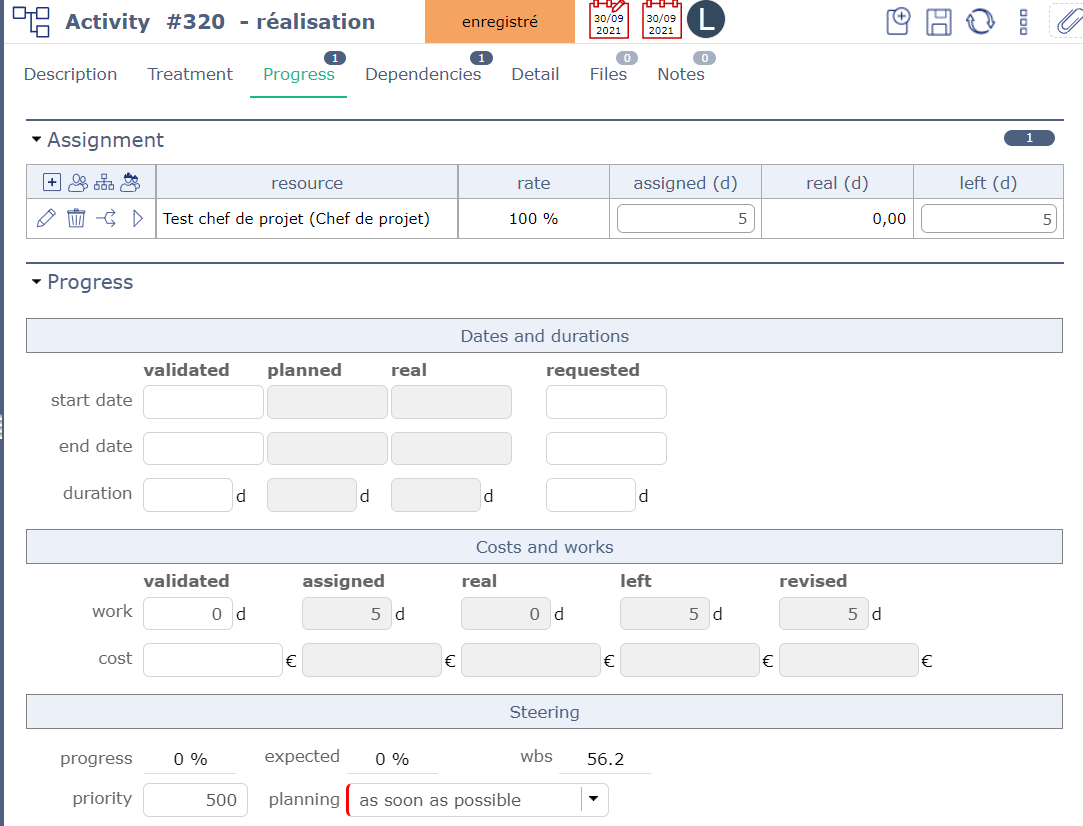

After clicking on the calculate capacity planning button (the calculator) using the date of 04/10, I have the following (see screenshot planning gantt) :
 -  Activity 319 starts on 04/10 but has one day of duration
- Activity 320 starts on 30/09/2021

Am I missing something regarding planned date ? Is it a bug ? I can provide more information and screenshots if needed.
Thanks for your help !
Best regards
Last edit: 30 Sep 2021 14:48 by ileduc.

Please Connexion or Create an account to join the conversation.

More
01 Oct 2021 11:15 #2 by babynus
Hi,
Yes, this seems weird.
Please check capacity of your resource : check that it is not null.
If issue is not there, please show sceenshots of Gant bar detail (right click on each bar)
Thanks

Babynus
Administrator of ProjeQtOr web site
The following user(s) said Thank You: ileduc

Please Connexion or Create an account to join the conversation.

More
01 Oct 2021 15:27 #3 by ileduc
Hi,
you are right ! Capacity was 0 for this resource.

I'm a bit confused because these resources were created from an import and I was assuming that everything was right... I will check it for every resource now.

It could be a great improvement to make the field mandatory in a future version, in order to make users look at this field.

Everything works fine now. Thank you for your help

Please Connexion or Create an account to join the conversation.

More
03 Oct 2021 19:08 #4 by babynus
Setting capacity to required may not be a good idea as it may fit some use cases to have zero capacity (avoid planning one resource, testing, ...)
But it may be a good idea to marks such cases in the planning (as some not planned activities, appering in purple)

Babynus
Administrator of ProjeQtOr web site

Please Connexion or Create an account to join the conversation.

Moderators: babynusprotion
Time to create page: 0.033 seconds
