Planned date & duration do not update

More
04 Jan 2022 11:48 #1 by vba
I have planed many tasks with dependencies. Once the project has been calculated, it has shifted tasks in 2024. So i try to plan them as i want.
But the planned date does not change accordingly.

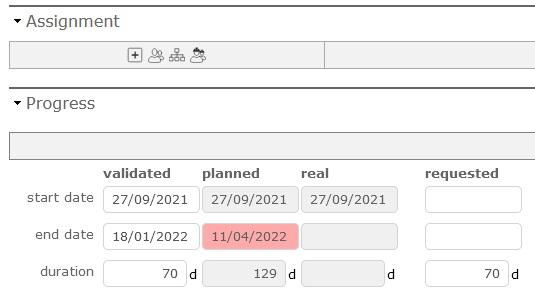

For example, i have a 70 days task, which began in September. It should end in January; How to make the planned value reflect the correct planning?
Attachments:

Please Connexion or Create an account to join the conversation.

More
04 Jan 2022 12:05 - 04 Jan 2022 12:07 #2 by alainforma
Hello,

I cannot answer to you with so little information cause I do not understand what you are doing.
But remember : Projeqtor is not a tool to draw nice plannings as wished. It calculates them depending on constraints and workload. The result showed is good or bad. Your work as Project Manager starts from that. Please explain or send attached files with pics.

Best regards
Last edit: 04 Jan 2022 12:07 by alainforma.

Please Connexion or Create an account to join the conversation.

More
04 Jan 2022 18:05 #3 by vba

Well, attached is another example.
I set the duration for a given task to 3 days, and set some workload (2h each). When click on calculator, it adjust the task duration to one day, maybe because the tool consider that resources are at 100% capacity so the duration is shorten to 1 day.
Is this the correct assomption ?
Attachments:

Please Connexion or Create an account to join the conversation.

More
05 Jan 2022 09:27 #4 by Arkhanje
Hello,

ProjeQtOr is software that is primarily based on effort if nothing indicates otherwise.

The validated dates are the dates that you want to respect but, except in exceptional cases, they have no impact on the planning.

The planned dates are those calculated by the software according to all the constraints that you give it : dependencies, priority, FTE of the resource, calendar, absences, periods, rate, planning mode, etc.

The values ​​that you enter in the validated dates are only there to compare with the planned dates to identify any deviation or differences.

So when you enter 70 days in the "validated", the software tells you that with the data you gave it, this date is not possible to keep, it therefore turns red and plans the best while respecting the workload.

You have a lot of levers in ProjeQtOr to save time on projects, it's up to you to determine what to modify within the constraints of your project.

Please Connexion or Create an account to join the conversation.

More
05 Jan 2022 10:27 - 05 Jan 2022 10:32 #5 by alainforma
if A) Only data written on valided : It keeps that to start to planify : so : expected ( valided) = planified  = nice draws = nice Gantt  = No forecasts

if B ) Data are written on validated but workload is given too ( assigned work) : it calculates and planify the workload, then you have to compare the result beetween valided ( expected) and calculated ( the reality's coming based on effort)

if C) Data is given only on workload ( effort) : it calcules the reality coming but you compare this result to nothing.
Last edit: 05 Jan 2022 10:32 by alainforma.

Please Connexion or Create an account to join the conversation.

More
05 Jan 2022 11:27 #6 by vba
Thank you for all your replies.

Once activites are listed and sequenced, planning an activity is partially based on calculation (activity resource requirements, resource calendars, amount of work, etc...), but also involve others factors like exper judgment, analogous estimating or previous experience.
For example, for a given task, let's say a firewall rule setup, the workload will be only 0,5d, but the duration will be 10 day due to external factors. Thoses external factors may be diverses and variable over time (process, incident, ..).
Other example is when you don't have full time resource -- many IT projects operate with matrix organization. You even don't have a fixed rate resource assignement, and it will perform the assigned task based on his team priority (incident generaly take precedence for example).

The tool can calculate planning based on ultiples factors as you listed, this is very helpfull. But it is alway up to the project manager to monitor and adjust workload and duration, based on real, environnemental factor and experience.
Tis has nothing related to "wish" or "nice gantt". This is related to real project management.

So, is there a possibilité to manually take control of this two key elements (workload and duration), letting the tool to calcultae dates, capacity planning, alerting, etc -- everything Projeqtor do very well.

Than you

Please Connexion or Create an account to join the conversation.
