Error with gantt

More
19 Aoû 2016 10:46 #1 by Jonathan02500
Hello,
I have a question about gannt creation.

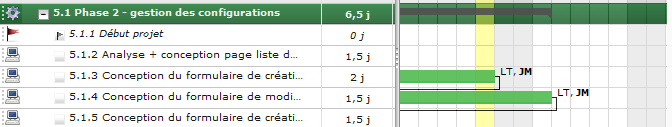

When i check my gantt i can see old done projects always planned to today ?
(As you can see in attachment :

)

All activities are done and also my project so i don't know why i can see this project.

Have a good day
Attachments:

Please Connexion or Create an account to join the conversation.

More
19 Aoû 2016 14:09 #2 by babynus
Replied by babynus on topic Error with gantt
1) Did you re-claculate plannig of your project ?
2) can you show print screen of the project detail ?

Babynus
Administrator of ProjeQtOr web site

Please Connexion or Create an account to join the conversation.

More
19 Aoû 2016 14:27 #3 by Jonathan02500
Replied by Jonathan02500 on topic Error with gantt
Yes i recalculated it.

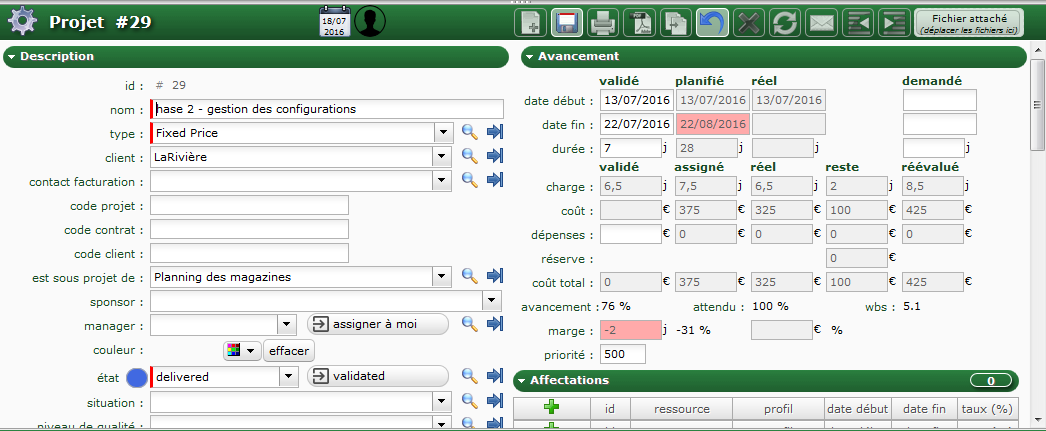

You can find in attachment the printscreen of my project
Attachments:

Please Connexion or Create an account to join the conversation.

More
21 Aoû 2016 23:26 #4 by babynus
Replied by babynus on topic Error with gantt
You project has 2 days of left work.
So these two days are always planned from recalculation of planning.

Babynus
Administrator of ProjeQtOr web site

Please Connexion or Create an account to join the conversation.

More
22 Aoû 2016 14:20 #5 by Jonathan02500
Replied by Jonathan02500 on topic Error with gantt
Ok thank you very much; problem solved !

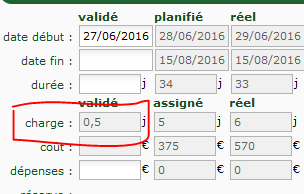

But i have one more question please, with some project i can't modifie validate work, do you know why ?
Attachments:

Please Connexion or Create an account to join the conversation.

More
24 Aoû 2016 23:21 #6 by babynus
Replied by babynus on topic Error with gantt
If depends on "consolidation of validated work" option you selected on global parameters screen.
If you did not change defaut value, consolidation is "only if set".
This means that if you have sturture like
A
...B
...C
......D
......E
You can for instance define validated work on B and C.
Sum will be consolidated on A, so validated work on A is locked (because it is calculated).
If you don't set validated work on D and E does not matter : zero values will not overwrite existing value on C. But if you start and entrer validated work on D, you have to also define it on E, as sum will be consolidated on C.

Hope this is clear. :silly:

Babynus
Administrator of ProjeQtOr web site

Please Connexion or Create an account to join the conversation.
