ProjeQtOr free project management software - Difference on planning between 6.1.1 and 6.1.3 ? - ProjeQtOr

Prochaines sessions de formation

Les prochaines formations et démonstrations sont ouvertes, inscrivez-vous rapidement !



Démonstration de ProjeQtOr

(gratuit, sur inscription)

Mardi 23 avril (10h30-12h)

Jeudi 16 mai (16h-17h30)

Jeudi 13 juin (10h30-12h)




Planifiez avec ProjeQtOr

3 et 4 avril (9h - 12h30)




Administrez avec ProjeQtOr

10 et 11 avril (9h - 12h30)








Difference on planning between 6.1.1 and 6.1.3 ?

More
04 Avr 2017 08:48 - 04 Avr 2017 09:24 #1 by dnaton
Hello,

I continue my tests from a full new installation of the v6.1.3.

I created a project with validated date from 03/04 to 28/04, with a single activity for the moment, from 05/04 to 12/04



I allocate 2 ressources on this activity, one for 1 day and the second for 2 days.



I see now that the duration of the activity stay 6 days and not 3 days (like in v6.1.1) and find it good :-)

I decide also to upgrade my "PreProd environnement" which is in 6.1.1 to 6.1.3 to test this operation mode in my environnment....but it doesnt work like in the new 6.1.3 environnment :-(

And after Real allocation input four the user1, the field "Planned" is not updated : it is not the same in v6.1.1



Is there some parameters I need to put to have this operation mode ? It would be great because I find it is the right operation mode (workload don't have to change duration on a project, it can be really two different things)

Thanks

Regards,
Damien
.
ProjeQtOr v11.0.1 - Apache v2.4.56 - MariaDB v10.4.28 - PHP v8.2.4
Plugins installed : Personalized Translation 1.5 - Customization of screen 6.6

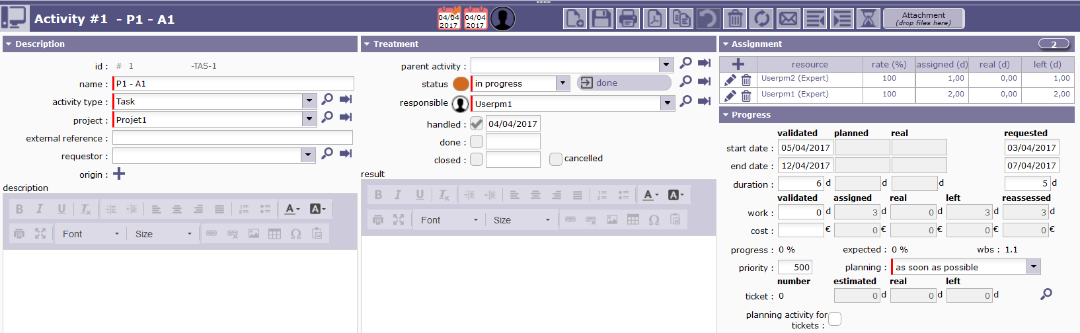

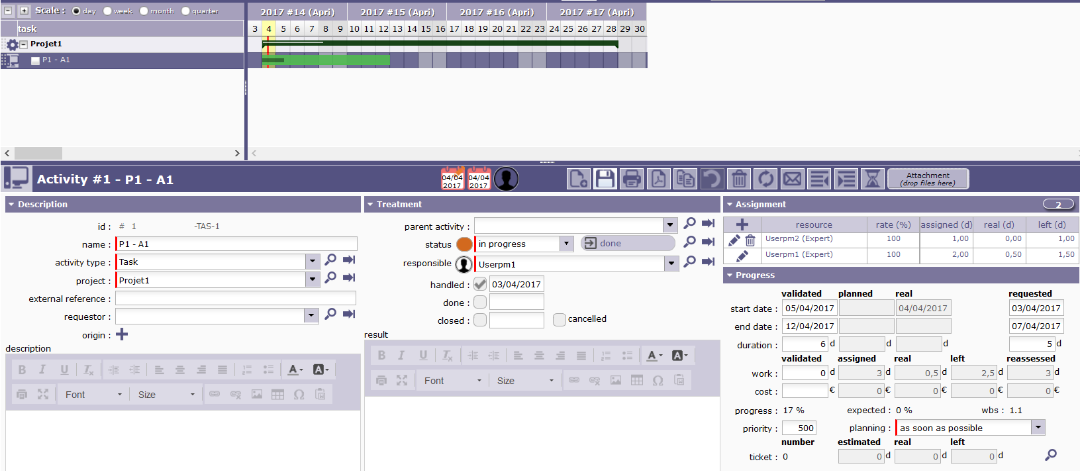

Attachments:
Last edit: 04 Avr 2017 09:24 by dnaton.

Please Connexion or Create an account to join the conversation.

More
05 Avr 2017 15:24 #2 by babynus
I think that on first test, you just did not run planing calcultation...

I see now that the duration of the activity stay 6 days and not 3 days (like in v6.1.1) and find it good :-)

In fact with your parameters it is not good : duration of the task should be 2 days. Try and re-calculate planning to see what I mean.

workload don't have to change duration on a project, it can be really two different things

You're wrong ! Workload drives the duration in a work driven management, and ProjeQtOr implements work driven management (also call effort driven).
But you're right on one side : duration and workload are 2 really different things.

Is there some parameters I need to put to have this operation mode ?

Yes : use fixed duration planning mode.
ASAP planning mode will calculate duration from workload to end as soon as possible.

Babynus
Administrator of ProjeQtOr web site

Please Connexion or Create an account to join the conversation.

Moderators: babynusprotion
Time to create page: 0.057 seconds

Paramétrages de cookies

×

Cookies fonctionnels

Ce site utilise des cookies pour assurer son bon fonctionnement et ne peuvent pas être désactivés de nos systèmes. Nous ne les utilisons pas à des fins publicitaires. Si ces cookies sont bloqués, certaines parties du site ne pourront pas fonctionner.

Session

Veuillez vous connecter pour voir vos activités!

Autres cookies

Ce site web utilise un certain nombre de cookies pour gérer, par exemple, les sessions utilisateurs.
