View ProjeQtOr On SourceForge.net
ProjeQtOr - Project Management Tool
Supportez nous sur Capterra
OIN - Open Invention Network
ProjeQtOr free project management software - affectation - ProjeQtOr

Prochaines Sessions

Les prochaines formations et démonstrations sont ouvertes, inscrivez-vous rapidement !



Démonstration de ProjeQtOr

(gratuit, sur inscription)


5 juin 2025 (16h-17h30)

19 juin 2025 (16h-17h30)

9 septembre 2025 (10h30-12h)




Planifiez avec ProjeQtOr

18 et 19 juin 2025 (9h-12h30)

17 et 18 septembre 2025 (9h-12h30)




Administrez avec ProjeQtOr

20 et 21 mai 2025 (9h-12h30)

25 et 26 juin 2025 (9h-12h30)

24 et 25 septembre 2025 (9h-12h30)







affectation

More
26 Sep 2017 18:24 #1 by Durou C
affectation was created by Durou C
If ressource is affected on project, is it automatically affected on sub-Project ?
If I put 50% rate on affectation on project, how is the rate of the sub-project ?

Please Connexion or Create an account to join the conversation.

More
28 Sep 2017 00:47 #2 by babynus
Replied by babynus on topic affectation
Equal !
(50%)

Babynus
Administrator of ProjeQtOr web site

Please Connexion or Create an account to join the conversation.

More
28 Sep 2017 08:54 #3 by Durou C
Replied by Durou C on topic affectation
but if I go on ressource affectation, I can see all of affectation, at the end of the allocation table of the resource, I have the total of affectation rate... and it is an addition of the rates of the projects and sub-projects
If my ressource is affect at 50% on project and 50% also on the sub-project , the general rate is 100% ... it's not true.

Please Connexion or Create an account to join the conversation.

More
28 Sep 2017 10:00 #4 by babynus
Replied by babynus on topic affectation
Affectation rates do not add.
They are just constraints applied at each project level.

Babynus
Administrator of ProjeQtOr web site

Please Connexion or Create an account to join the conversation.

More
28 Sep 2017 11:21 #5 by Durou C
Replied by Durou C on topic affectation

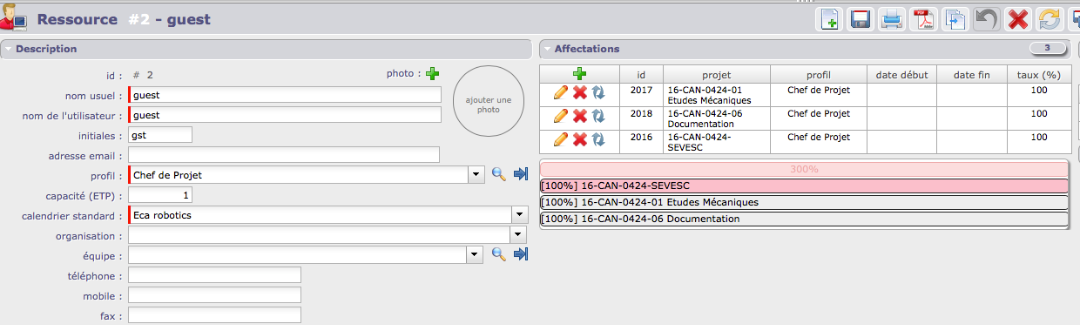

I did an example in attachement file:

this ressource is affect on 16-CAN-0424 (project) 100%
and 16-CAN-0424-01 (sub-project) 100%
and 16-CAN-0424-06 (sub-project) 100%

total is 300% and not 100%

is it correct ?
Attachments:

Please Connexion or Create an account to join the conversation.

More
28 Sep 2017 12:02 #6 by babynus
Replied by babynus on topic affectation
Yes, but this does not mean resource will work 3 days per day.
Just that resource is able to work on 100% on 3 different projects, but won't be planned 3 days per day.
Project priorities and dependencies will define on wich project resouce will work first.

Babynus
Administrator of ProjeQtOr web site

Please Connexion or Create an account to join the conversation.

Moderators: babynusprotion
Time to create page: 0.046 seconds

Paramétrages de cookies

×

Cookies fonctionnels

Ce site utilise des cookies pour assurer son bon fonctionnement et ne peuvent pas être désactivés de nos systèmes. Nous ne les utilisons pas à des fins publicitaires. Si ces cookies sont bloqués, certaines parties du site ne pourront pas fonctionner.

Session

Veuillez vous connecter pour voir vos activités!

Autres cookies

Ce site web utilise un certain nombre de cookies pour gérer, par exemple, les sessions utilisateurs.
