View ProjeQtOr On SourceForge.net
ProjeQtOr - Project Management Tool
Supportez nous sur Capterra
OIN - Open Invention Network
ProjeQtOr free project management software - [SOLVED] real work allocation unit change. - ProjeQtOr

Prochaines Sessions

Les prochaines formations et démonstrations sont ouvertes, inscrivez-vous rapidement !



Démonstration de ProjeQtOr

(gratuit, sur inscription)


13 mai 2025 (10h30-12h)

5 juin 2025 (16h-17h30)




Planifiez avec ProjeQtOr

14 et 15 mai 2025 (9h-12h30)

18 et 19 juin 2025 (9h-12h30)




Administrez avec ProjeQtOr

20 et 21 mai (9h-12h30)

25 et 26 juin (9h-12h30)







[SOLVED] real work allocation unit change.

More
02 Mai 2018 13:33 #1 by Iaurkano
hi all,

We need to change real work allocation unit.

today, we are using "days". We would like to change to hour. so my question is.

what's happend on real work already set in days in our projects ?

is it possible to change this value without issue ?

what will happen to the projects for which the charges are already made in days, and for which future charges will be made in hours ?

could you help me to see more clearly?

Thank's for all.

Please Connexion or Create an account to join the conversation.

More
02 Mai 2018 14:51 #2 by alainforma
HI,

You can modify real work allocation unit from days to hours.

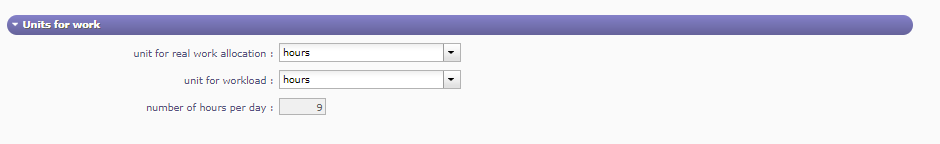

To do this, go in global parameters screen, section work time then go down to unit for work.

Conversion is done automaticly. I suggest you to do this operation, just and if possible before the begining of the project, to be sure that everybody use the same base of work allocation all along. ;-)
Attachments:

Please Connexion or Create an account to join the conversation.

More
02 Mai 2018 16:37 #3 by Iaurkano
Thank's for reply.

is it possible to charge more than the number of hour in a day. I mean if i set 8h by day. is it possible for a ressource to charge 9h for a day ?

thank's.

Please Connexion or Create an account to join the conversation.

More
02 Mai 2018 18:09 - 02 Mai 2018 18:24 #4 by alainforma
you can change the number of hour per day as you want, nine for instance.


Also, if your resource works 9 hours and not 8 as planned , you can impute 9 h on his imputation time table, a red color will indicate this anomaly at the bottom of the column.
As well, no worries about conversion.
You're welcome.
Attachments:
Last edit: 02 Mai 2018 18:24 by alainforma.

Please Connexion or Create an account to join the conversation.

More
03 Mai 2018 08:12 #5 by Iaurkano
thank's a lot for all of these explanations.

Best regards.

Please Connexion or Create an account to join the conversation.

More
03 Mai 2018 20:57 #6 by babynus

is it possible to charge more than the number of hour in a day. I mean if i set 8h by day. is it possible for a ressource to charge 9h for a day ?

Yes, you can input more that 8hours per day even if you define 8 hours per dayn exactly as you can enter more thant 1 day per day if you enter work in days.
But planning will always paln only 1 day per day, so 8 hours per day

Babynus
Administrator of ProjeQtOr web site

Please Connexion or Create an account to join the conversation.

Moderators: babynusprotion
Time to create page: 0.059 seconds

Paramétrages de cookies

×

Cookies fonctionnels

Ce site utilise des cookies pour assurer son bon fonctionnement et ne peuvent pas être désactivés de nos systèmes. Nous ne les utilisons pas à des fins publicitaires. Si ces cookies sont bloqués, certaines parties du site ne pourront pas fonctionner.

Session

Veuillez vous connecter pour voir vos activités!

Autres cookies

Ce site web utilise un certain nombre de cookies pour gérer, par exemple, les sessions utilisateurs.
