How to check for concurrent activities about a resource

More
11 Jui 2019 13:08 #13 by babynus
You can check with a right click on bar on Gantt chart.
If there is some planned work, you'll see day by day planning. If not ypu'll have message to run planning calculation.

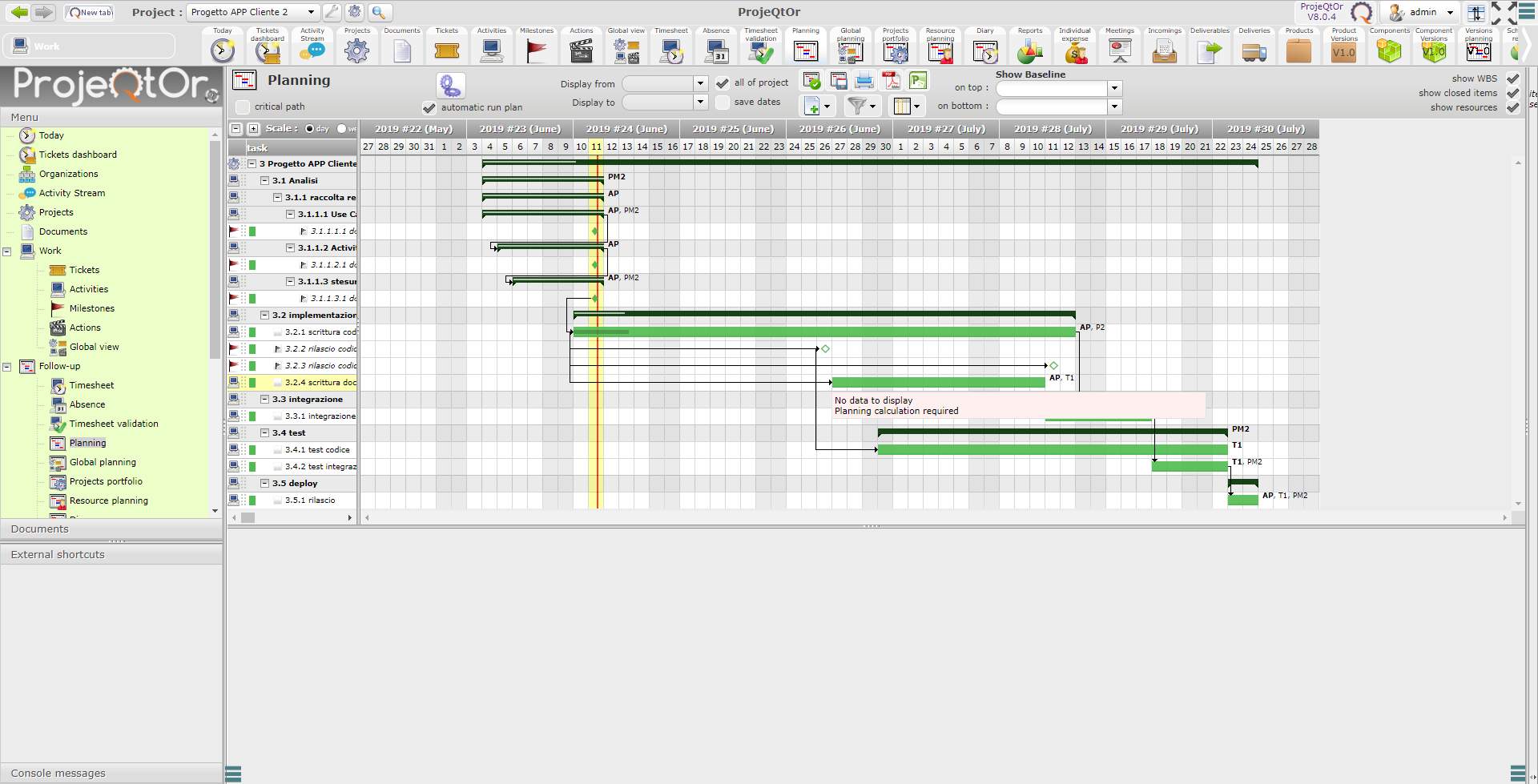

If projects are not planned, it may be due to:
- project type => be sure NOT to select Administrative and Template
- fix planning => be sure that this checkbox is not ticked

Babynus
Administrator of ProjeQtOr web site

Please Connexion or Create an account to join the conversation.

More
11 Jui 2019 14:04 #14 by al_rodin
Hello babynus,
it's me again... :-) this story is very intriguing for me..

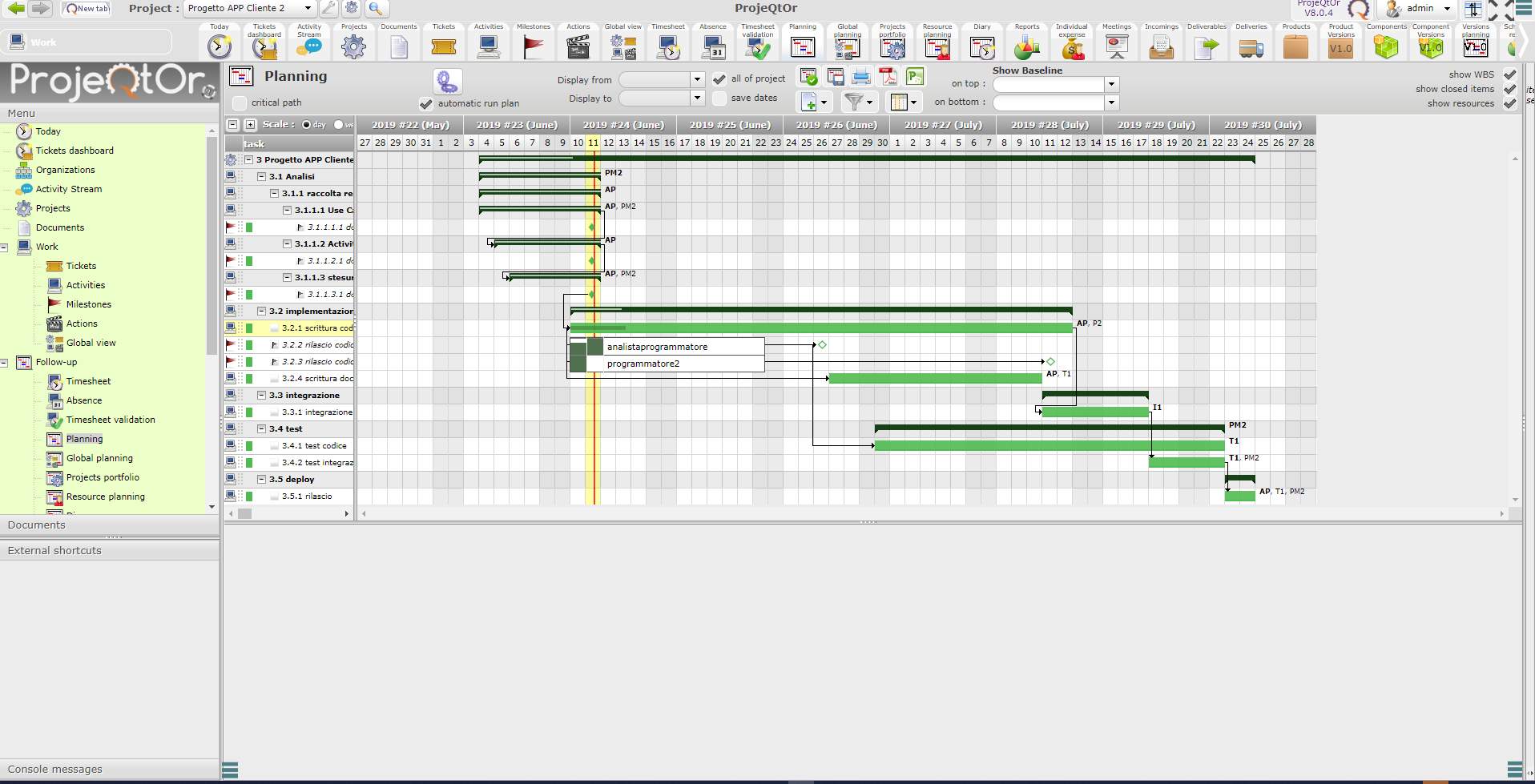

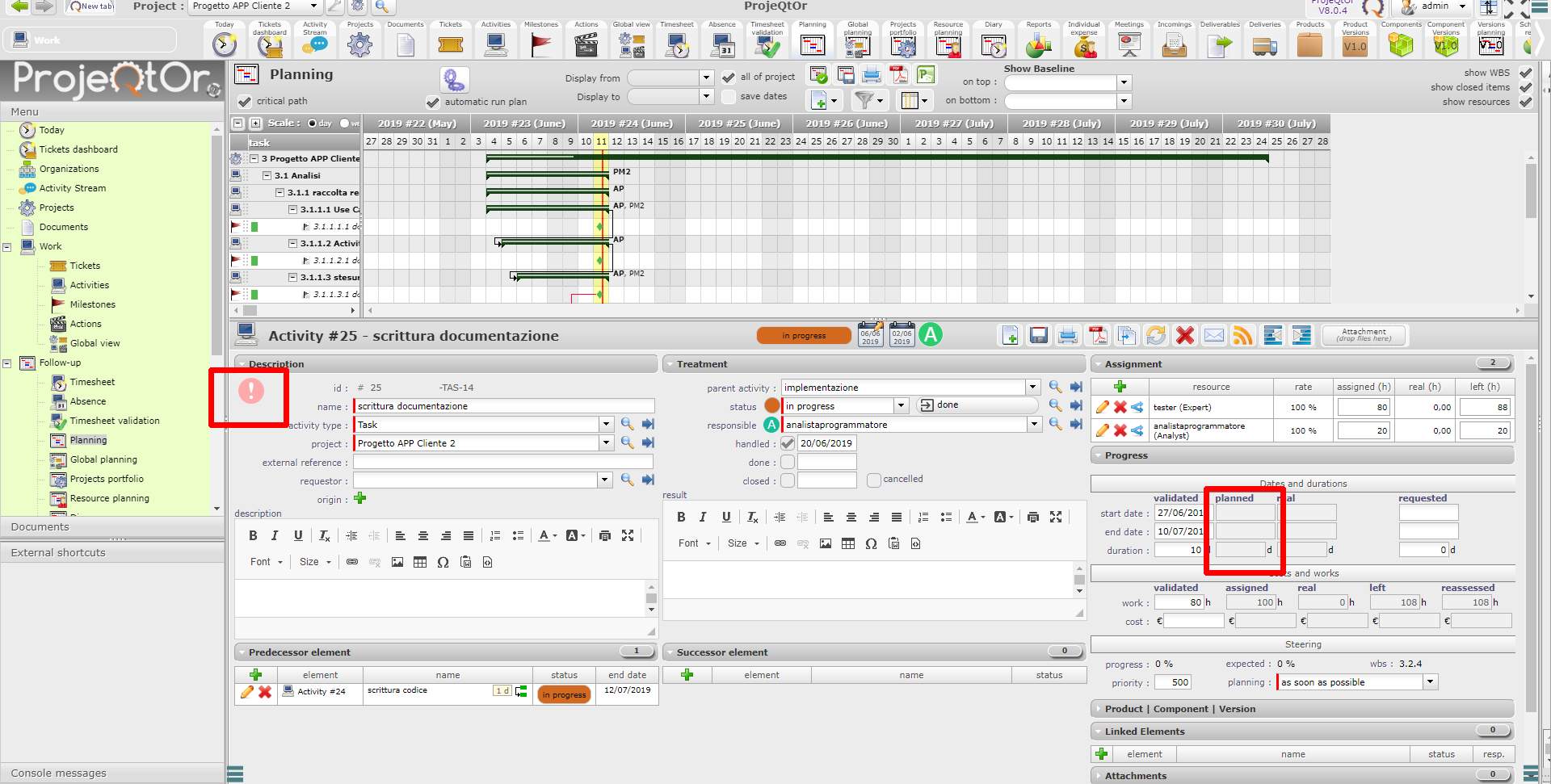

In the attachments you can see that the planned work is only for activities that have some done work. The activities to come are those that demand re-planning. If I check for a re-plan. The planned starting and ending dates are not filled after a re-evaluation. The Project is marked as Fixed Price and" fix planning" is not checked.

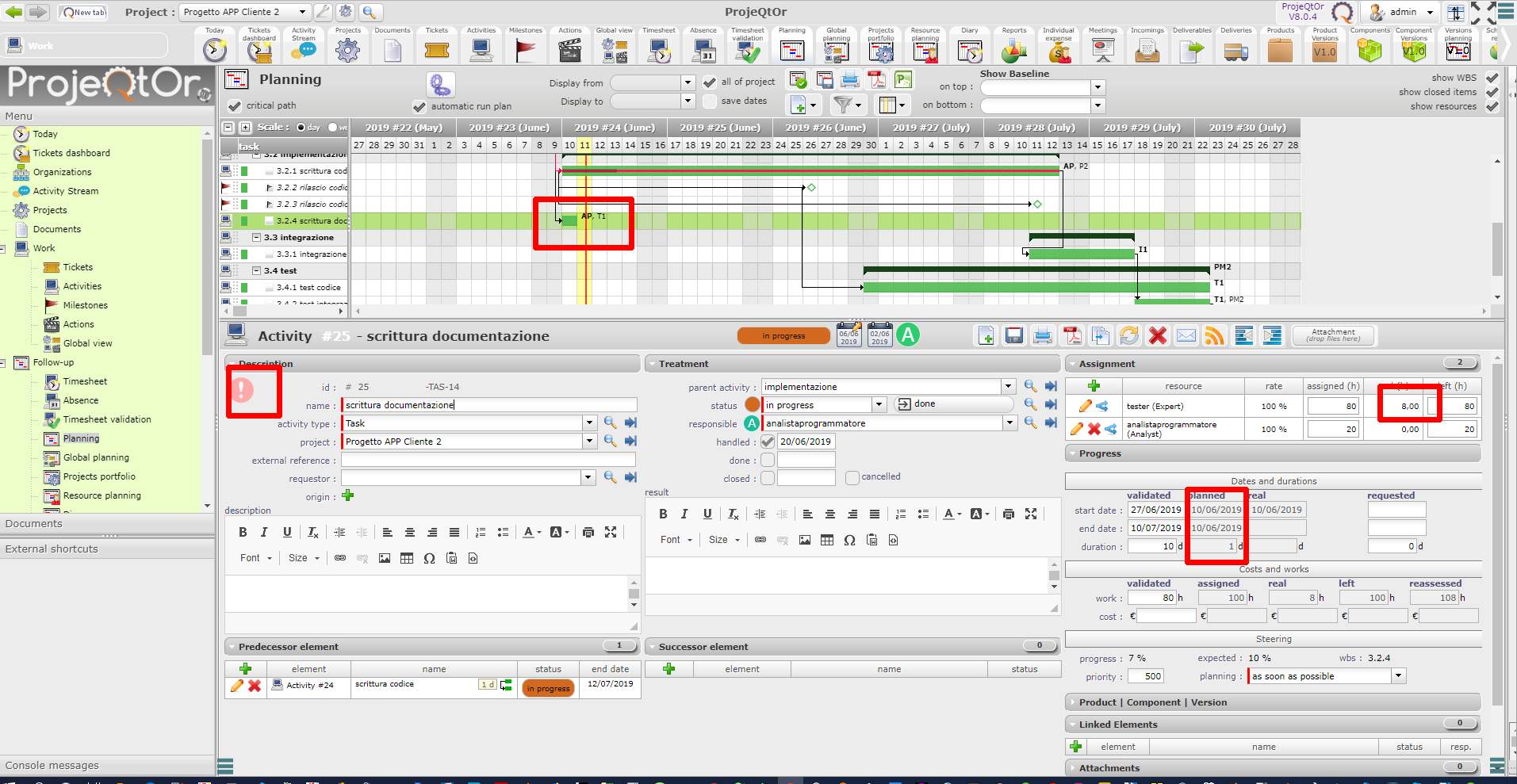

Nevertheless the planning dates are always empty. They start to be filled if I put some real work in the activity, even if it's not yet planned (eg:. like in my case, documentation writing, planned staring fron w26. If I start now this activity and attach some work done, the planning dates are finally visible.



Sorry for this, but this behavior sounds strange to me, even after reading the manual.
Attachments:

Please Connexion or Create an account to join the conversation.

More
11 Jui 2019 14:10 #15 by babynus
Please check resource capacity.
Resource capacity should not be null. Default is 1 (FTE).

Babynus
Administrator of ProjeQtOr web site

Please Connexion or Create an account to join the conversation.

More
11 Jui 2019 14:36 - 11 Jui 2019 22:50 #16 by al_rodin
Spot it! It was due to FTE set to zero! Babynus, I'm currently the happiest PM on the earth! :-D many many thanks! I completely forgot the FTE, and yes... I used it for other resources :-(
Have a nice day!
Last edit: 11 Jui 2019 22:50 by al_rodin.
