ProjeQtOr free project management software - [SOLVED] Manual real work - ProjeQtOr

[SOLVED] Manual real work

More
06 Feb 2019 11:15 #1 by jmmbb
Manual real work was created by jmmbb
Hello,

I just install V 7.4.0.
Manual real work on activities work fine for some but there is an issue on other.

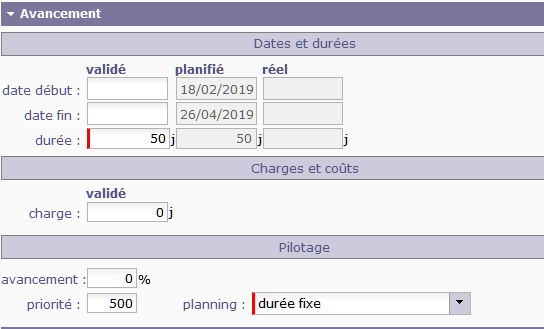

This is one is ok (take over is possible on progress) :

This one, same context (same project, fix duration,...) is OK

regards,
Attachments:

Please Log in or Create an account to join the conversation.

More
06 Feb 2019 11:24 - 06 Feb 2019 11:27 #2 by Gautier
Replied by Gautier on topic Manual real work
Hello,
Did you assign someone on your activity ?

As an assignment gives possibility to enter real work on the activity through Timesheets, activities with assignments cannot be in "Manual Progress" mode.
Last edit: 06 Feb 2019 11:27 by babynus.

Please Log in or Create an account to join the conversation.

More
06 Feb 2019 12:12 #3 by jmmbb
Replied by jmmbb on topic Manual real work
That's does matter.
Assignment is needed to note who is responsabile for a task and to show task for team member.
If a task whith assignment can't be manually followed, we lose one expected functionnality...

Please Log in or Create an account to join the conversation.

More
06 Feb 2019 13:01 #4 by babynus
Replied by babynus on topic Manual real work
Assignment is not mandatory to know who is responsible for the activity as you have the field "Responsible" for this.
You can easily see who is responsible and a resource can see items he is responsible for (on today screen, with filter, ...)
Of course you can have one only responsible.

To point out that several resource can take part on one activity, assignment seems the best point of view.
And we tried (during devs) and allow manual progress on activities with assignments.
First issue is that automatically assigned resource can enter real work on the activity through timesheet.
So activity cannot be managed in "manual progress" any more. But this is not the major issue as we could automatically remove the "manual progress" mode on first entered real work.
The real issue is that if you have Assignement, you can define Assigned Work, Left Work and Planned Work (=Left work as long as no real work is entered).
And ProjeQtOr core automatically sums up Assigned data to the activity (assigned, left and planned).
So Real would be calculated from Validated x Progress, and left from assignment... so data would be incoherent.
At the opposit, if we don't sum up values from assignment, we may have data inconsistency between assignent and activity.
That(s why we reverted to what was planned on analysis of need to remove Manual Progress when an assignment exist on the activity.

Babynus
Administrator of ProjeQtOr web site

Please Log in or Create an account to join the conversation.

More
06 Feb 2019 13:12 #5 by jmmbb
Replied by jmmbb on topic Manual real work
You're right, it's a mystake.
responsabile is enought to restrict elements view and with no allocation, manual setup work fine.

Please Log in or Create an account to join the conversation.

Moderators: babynusprotion
Time to create page: 0.054 seconds

Cookies settings

×

Functional Cookies

Ce site utilise des cookies pour assurer son bon fonctionnement et ne peuvent pas être désactivés de nos systèmes. Nous ne les utilisons pas à des fins publicitaires. Si ces cookies sont bloqués, certaines parties du site ne pourront pas fonctionner.

Session

Please login to see yours activities!

Other cookies

Ce site web utilise un certain nombre de cookies pour gérer, par exemple, les sessions utilisateurs.
