Hi,
I'm trying to set my project planning, but I faced to a problem :

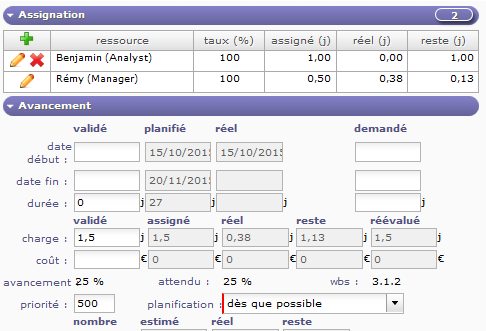

- The duration of an activity is much longer than it must be... I planned 1,5day and the activity is planned with 27days. I don't understand why, could you help me ?
You'll see the details in the attached files
In affectation list, that you'll find in 3 points :
- affectation list in the resource screen
- affectation list in the project screen
- affectation screen
Could you show tasks before the one in issue ?
I guess assigned resources are busy on other tasks.
Please also check (and possibly display) report "planning">>"Monthly planning resource/project/activity".
En poursuivant votre navigation, vous acceptez le dépôt de cookies tiers destinés au bon fonctionnement et à la sécurisation du site (gestion de session, reCaptcha) et à une analyse statistique anonymisée des accès sur notre site (Google Analytics). Si vous vous inscrivez, les informations que vous fournirez ne seront jamais divulguées à un tiers sous quelque forme que ce soit. En savoir plus
Cookies settings
×
Functional Cookies
Ce site utilise des cookies pour assurer son bon fonctionnement et ne peuvent pas être désactivés de nos systèmes. Nous ne les utilisons pas à des fins publicitaires. Si ces cookies sont bloqués, certaines parties du site ne pourront pas fonctionner.
Session
Please login to see yours activities!
Other cookies
Ce site web utilise un certain nombre de cookies pour gérer, par exemple, les sessions utilisateurs.
