manual planning & planning calculation

More
31 Jan 2022 16:18 #1 by vba
Hello team.

I'm trying to adjust end date of a manual planed task.
There is no assignement, the predecessor is closed, and i do not modify the start date, only the end date to adjust duration.
I ran planning calculation. Others task correctly adjusted but not this one.
AFAIK there are not other constraints on this task.

Is there any way to view some sort of calculation trace to see what could be the cause?
Thank you for your great support

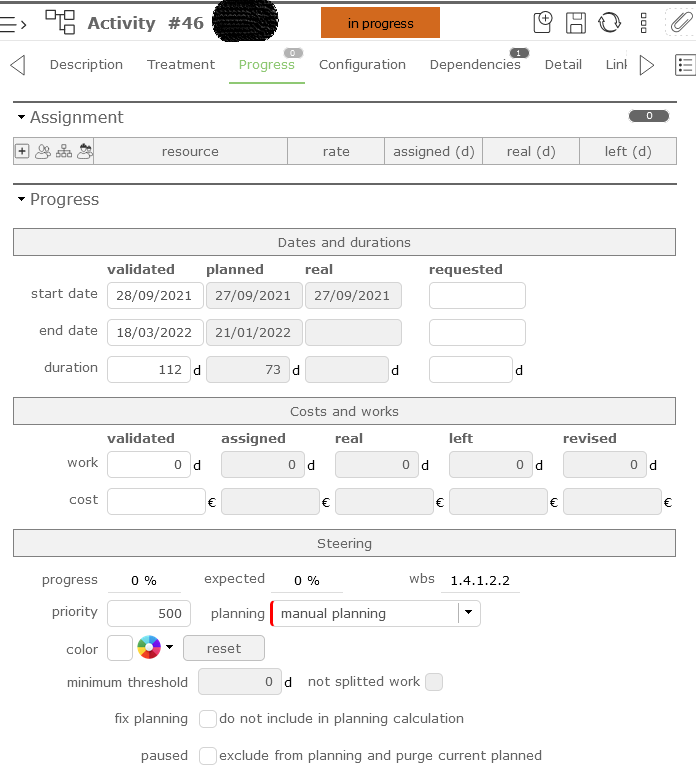

Attachments:

Please Log in or Create an account to join the conversation.

More
01 Feb 2022 09:12 #2 by Arkhanje
Hello,

Manual planning, as its name suggests, is planned exclusively by hand and takes priority over all other planning modes even without any constraint.

To modify the planned dates in this mode, edit the assignment on the activity or go to the "planned interventions view" screen to view and modify the assignments.

The schedule calculation will never modify your schedule in this mode.

Please Log in or Create an account to join the conversation.

More
01 Feb 2022 09:49 #3 by vba
Thank you for your reply and help.
Does this mean an assignment is mandatory to a manually planned task?
I just would like to manually set start date and end date to this task which represent a given period of time, but with no assignment on it.

Please Log in or Create an account to join the conversation.

More
01 Feb 2022 09:58 #4 by Arkhanje
yes, there is no point in working without assignment and assigned workload for the manual planning mode.

the "fixed duration" planning mode should work for you.

Please Log in or Create an account to join the conversation.

More
07 Feb 2022 15:12 #5 by vba
Thank you for you reply.
Unfortunately the only way to modify duration -- and end date -- in my case was to drag the bar on the gantt chart. And this, whatever scheduling options i choosed. Then, the dates within the activity, and the gantt reflected correctly the given date/duration.

btw, thank you again for your support.

Please Log in or Create an account to join the conversation.

More
08 Feb 2022 09:35 #6 by Arkhanje
I'm not sure why this would be the only solution, but you can drag the bar of an activity in "fixed duration" planning mode directly onto the Gantt.

Please Log in or Create an account to join the conversation.

Moderators: babynusprotion
Time to create page: 0.040 seconds

Cookies settings

×

Functional Cookies

Ce site utilise des cookies pour assurer son bon fonctionnement et ne peuvent pas être désactivés de nos systèmes. Nous ne les utilisons pas à des fins publicitaires. Si ces cookies sont bloqués, certaines parties du site ne pourront pas fonctionner.

Session

Please login to see yours activities!

Other cookies

Ce site web utilise un certain nombre de cookies pour gérer, par exemple, les sessions utilisateurs.
