[SOLVED] How to detect surcharge on the same task?

More
20 Oct 2015 16:14 #1 by El Wallos
Hi

How can I check if one ressource is assigned on two different tasks at the same time (100%)?

For example, RR is assigned on two projects the same day (20 Oct 2015) and no alert is displayed, so what is the way to detecte it?

Martin

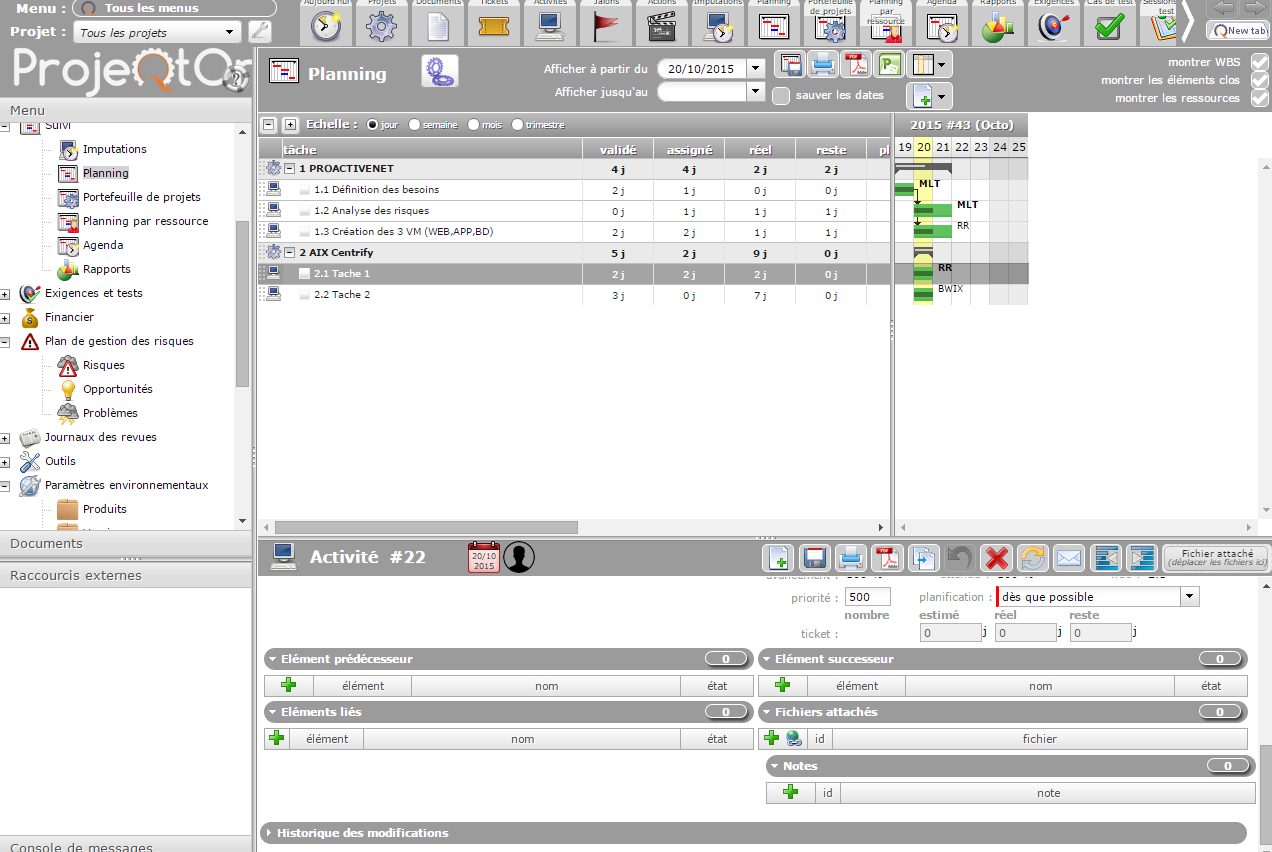

Attachments:

Please Log in or Create an account to join the conversation.

More
20 Oct 2015 17:05 #2 by El Wallos
Sorry for my english, the question was:

How to detect overload on the same ressource?

Please Log in or Create an account to join the conversation.

More
21 Oct 2015 09:51 #3 by babynus

How can I check if one ressource is assigned on two different tasks at the same time (100%)?
For example, RR is assigned on two projects the same day (20 Oct 2015) and no alert is displayed, so what is the way to detecte it?

There is no alert because it is not an issue : resource can be affected on same period on several projects, and total affectation can be more than 100%.
You can see affectation summary on resource screen.

How to detect overload on the same ressource?

There is not overload of resource in ProjeQtOr planning !!!
If resource is planned on 2 tasks that should come same day then one of the two is extended on following days (witch is delayed depends on priority of tasks, have a look at priority in planning calculation in the user manual).

Babynus
Administrator of ProjeQtOr web site

Please Log in or Create an account to join the conversation.

More
21 Oct 2015 10:20 #4 by El Wallos
Thanks Babynus, right now, it is more clear for me.

What's happen if the two activities have the same priority? ProjeQtOr choses one with "random logic" to plan?

Please Log in or Create an account to join the conversation.

More
21 Oct 2015 10:24 #5 by babynus

What's happen if the two activities have the same priority? ProjeQtOr choses one with "random logic" to plan?

Default priority is WBS order.

Babynus
Administrator of ProjeQtOr web site
The following user(s) said Thank You: El Wallos

Please Log in or Create an account to join the conversation.

More
26 Oct 2015 09:19 #6 by El Wallos
Thanks Babynus,

Have a good day

Please Log in or Create an account to join the conversation.

Moderators: babynusprotion
Time to create page: 0.067 seconds

Cookies settings

×

Functional Cookies

Ce site utilise des cookies pour assurer son bon fonctionnement et ne peuvent pas être désactivés de nos systèmes. Nous ne les utilisons pas à des fins publicitaires. Si ces cookies sont bloqués, certaines parties du site ne pourront pas fonctionner.

Session

Please login to see yours activities!

Other cookies

Ce site web utilise un certain nombre de cookies pour gérer, par exemple, les sessions utilisateurs.
