ProjeQtOr free project management software - Reports on Planning and real work mix up real and planned work (?) - ProjeQtOr

Prochaines Sessions

Les prochaines formations et démonstrations sont ouvertes, inscrivez-vous rapidement !



Démonstration de ProjeQtOr

(gratuit, sur inscription)


5 juin 2025 (16h-17h30)

19 juin 2025 (16h-17h30)

9 septembre 2025 (10h30-12h)




Planifiez avec ProjeQtOr

18 et 19 juin 2025 (9h-12h30)

17 et 18 septembre 2025 (9h-12h30)




Administrez avec ProjeQtOr

20 et 21 mai 2025 (9h-12h30)

25 et 26 juin 2025 (9h-12h30)

24 et 25 septembre 2025 (9h-12h30)







Reports on Planning and real work mix up real and planned work (?)

More
27 Jui 2017 13:26 - 27 Jui 2017 13:27 #1 by NarayanAras
In the reports belonging to the Planning and Real work sections, the planned and real work are treated as equivalent, and added up column-wise and row-wise.

Why is this so?

At least for the past dates, we know whether the resource has worked as per plan.
(Assuming that he has updated whatever work he has done on a daily basis).

So, of he has not entered any work hours for a day in the past, then it should be counted as zero.
Instead, the original planned value is retained and used for the summation.

This would create a mix of real and imaginary work.

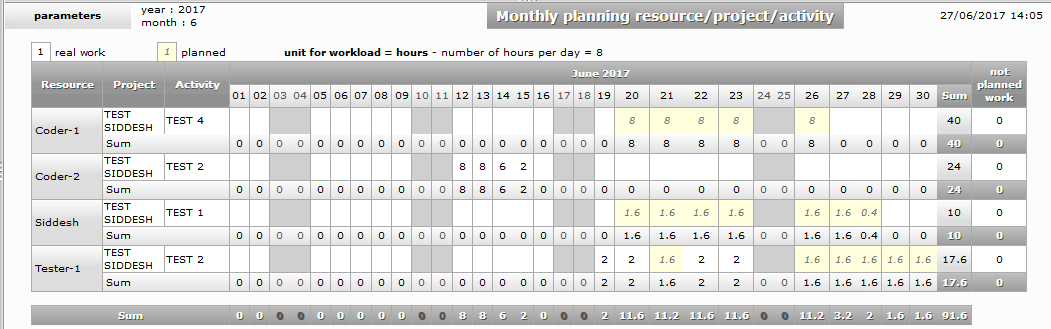

For example, PFA screenshot taken on 27th June. It shows four (imaginary) resources.
If you see the past week (22nd June onward), the cells show a mix of planned and real work.
As a result, the summed values are also a mix of planned and real work.

So why not keep two separate rows, to add up the planned and actual work separately?
Also, what is meant by "not planned work"? How is this derived?

BTW there is no context-sensitive help on this. Please include a full page!
Attachments:
Last edit: 27 Jui 2017 13:27 by NarayanAras.

Please Connexion or Create an account to join the conversation.

More
28 Jui 2017 10:38 #2 by babynus

In the reports belonging to the Planning and Real work sections, the planned and real work are treated as equivalent, and added up column-wise and row-wise.
Why is this so?

It is to get total work for items, whatever it is planned of real.
NB : for given item / day, if real exists, we take real, if not we take planned, so we do not "add" planned and real.

(Assuming that he has updated whatever work he has done on a daily basis).

And unfortunately, it is not always the case.

Also, what is meant by "not planned work"? How is this derived?

It is the work that could not be planned for resource because it allocation to project ends before he is able to complete all palnned tasks.

Babynus
Administrator of ProjeQtOr web site
The following user(s) said Thank You: NarayanAras

Please Connexion or Create an account to join the conversation.

Moderators: babynusprotion
Time to create page: 0.049 seconds

Paramétrages de cookies

×

Cookies fonctionnels

Ce site utilise des cookies pour assurer son bon fonctionnement et ne peuvent pas être désactivés de nos systèmes. Nous ne les utilisons pas à des fins publicitaires. Si ces cookies sont bloqués, certaines parties du site ne pourront pas fonctionner.

Session

Veuillez vous connecter pour voir vos activités!

Autres cookies

Ce site web utilise un certain nombre de cookies pour gérer, par exemple, les sessions utilisateurs.
